Flagship Project

Romero Gold-Copper Project

GoldQuest's 100%-owned flagship project with an Indicated Resource of 2.27M oz gold equivalent (plus 0.24M oz Inferred), located in the highly prospective Tireo Formation of the Dominican Republic.

Overview

Key Facts

100%

Ownership

Advanced

Stage

Gold-Copper

Commodity

118,000+

Meters Drilled

2.27M oz AuEq

Indicated

0.24M oz AuEq

Inferred

Project Description

About Romero

The Romero gold-copper deposit was discovered by GoldQuest in 2011 and represents one of the most significant mineral discoveries in the Dominican Republic in recent decades. The project is located within the Tireo Formation, a volcanic arc sequence that extends across central Hispaniola.

With over 118,000 meters of drilling completed, Romero hosts an Indicated Resource of 2.27 million ounces of gold equivalent (Indicated), with an additional 0.24 million ounces of gold equivalent in the Inferred category. The deposit is characterized by its amenability to conventional processing methods, with excellent metallurgical recoveries demonstrated through extensive test work.

A Preliminary Feasibility Study has confirmed robust project economics, positioning Romero as a compelling development opportunity with established infrastructure and an experienced local workforce.

Highlights

Why Romero

→Indicated Resource of 2.27M oz AuEq, plus 0.24M oz Inferred
→Excellent metallurgical recoveries with conventional processing
→Positive Preliminary Feasibility Study with robust returns
→Near existing infrastructure — roads, power, water
→Experienced management team with in-country track record
→100% owned with no royalties to third parties
→Considerable exploration upside within broader property
Mineral Resource

Resource Estimate

The Romero deposit hosts a substantial NI 43-101 gold-copper resource, reported on a gold-equivalent (AuEq) basis.

CategoryTonnesAuEq (g/t)Contained AuEqContained Au
Indicated20.23 Mt3.482,265,000 oz1,738,000 oz
Inferred3.02 Mt2.47240,000 oz197,000 oz

Romero Mineral Resource Estimate, effective September 27, 2016 (NI 43-101). Gold-equivalent (AuEq) grades and ounces. Mineral resources are not mineral reserves and do not have demonstrated economic viability. See the technical report for grades, cut-offs, and assumptions.

Pre-Feasibility Study · 2016

Robust Project Economics

Romero's NI 43-101 Pre-Feasibility Study outlines a high-margin underground gold-copper mine with strong returns — built on just 35% of the Indicated resource, leaving significant room to grow.

US$203M

After-Tax NPV (5%)

28%

After-Tax IRR

US$158.6M

Initial Capex

8 yrs

Mine Life

2,800 tpd

Throughput

US$595/oz

AISC (AuEq)

Metallurgical Recoveries

Gold 78.1% · Copper 94.6% · Silver 58.6% — via conventional flotation.

Probable Reserves

7.03 Mt containing 840,000 oz gold, 136 M lb copper, and 980,000 oz silver.

Per the NI 43-101 Pre-Feasibility Study, effective October 27, 2016 (base case US$1,300/oz gold, US$2.50/lb copper). See the full technical report for assumptions and disclosures.

In the Field

GoldQuest in the Field

GoldQuest's exploration team operates a field camp in San Juan de la Maguana — drilling, logging, and assaying core across the highly prospective Tireo Formation.

Diamond drilling in the field
Diamond drilling in the field
The GoldQuest crew logging drill core
The GoldQuest crew logging drill core
A GoldQuest geologist logging core
A GoldQuest geologist logging core
Examining mineralization in a core sample
Examining mineralization in a core sample
Labeled drill core at the field camp
Labeled drill core at the field camp
GoldQuest's exploration team at camp
GoldQuest's exploration team at camp
Geology

Maps & Cross Sections

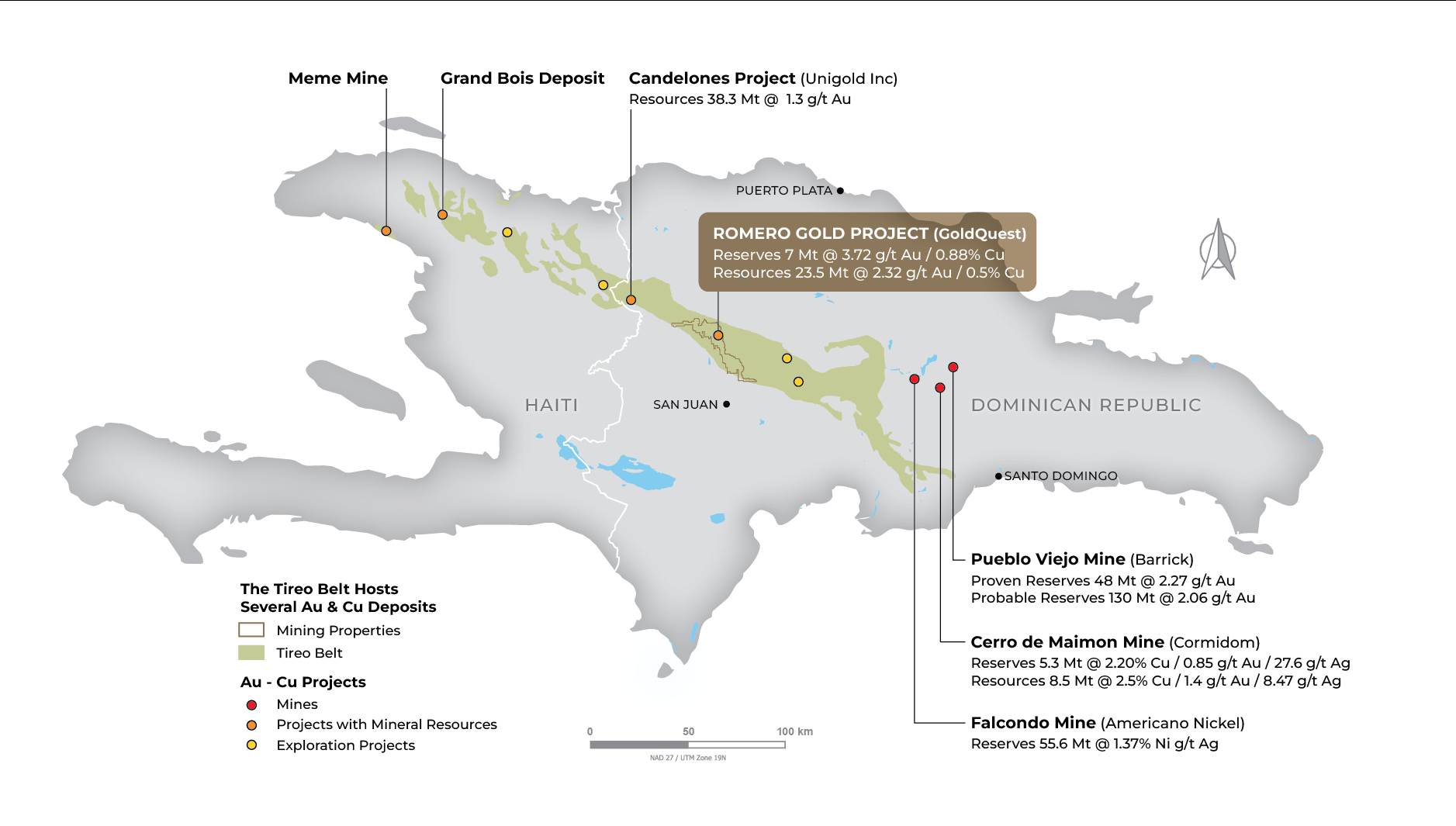

Dominican Republic Map with Mines

Location map showing GoldQuest properties and major mines in the Dominican Republic

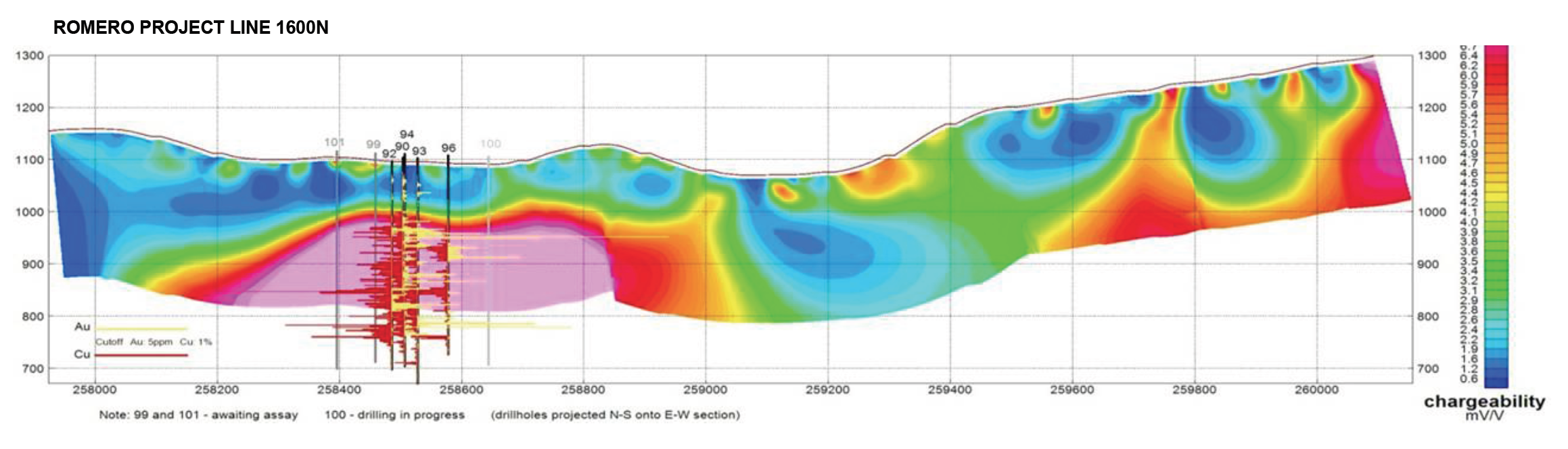

Romero Cross Section 1600N

Romero deposit cross section at 1600N showing mineralization zones

History

Project Timeline

2011

Initial gold-copper discovery at Romero

2012

Maiden resource estimate published

2014

Updated resource estimate with significant increase

2016

Preliminary Feasibility Study completed

2022

NI 43-101 Technical Report updated

2025

Continued infill and exploration drilling

2026

Ongoing advancement and optimization studies
